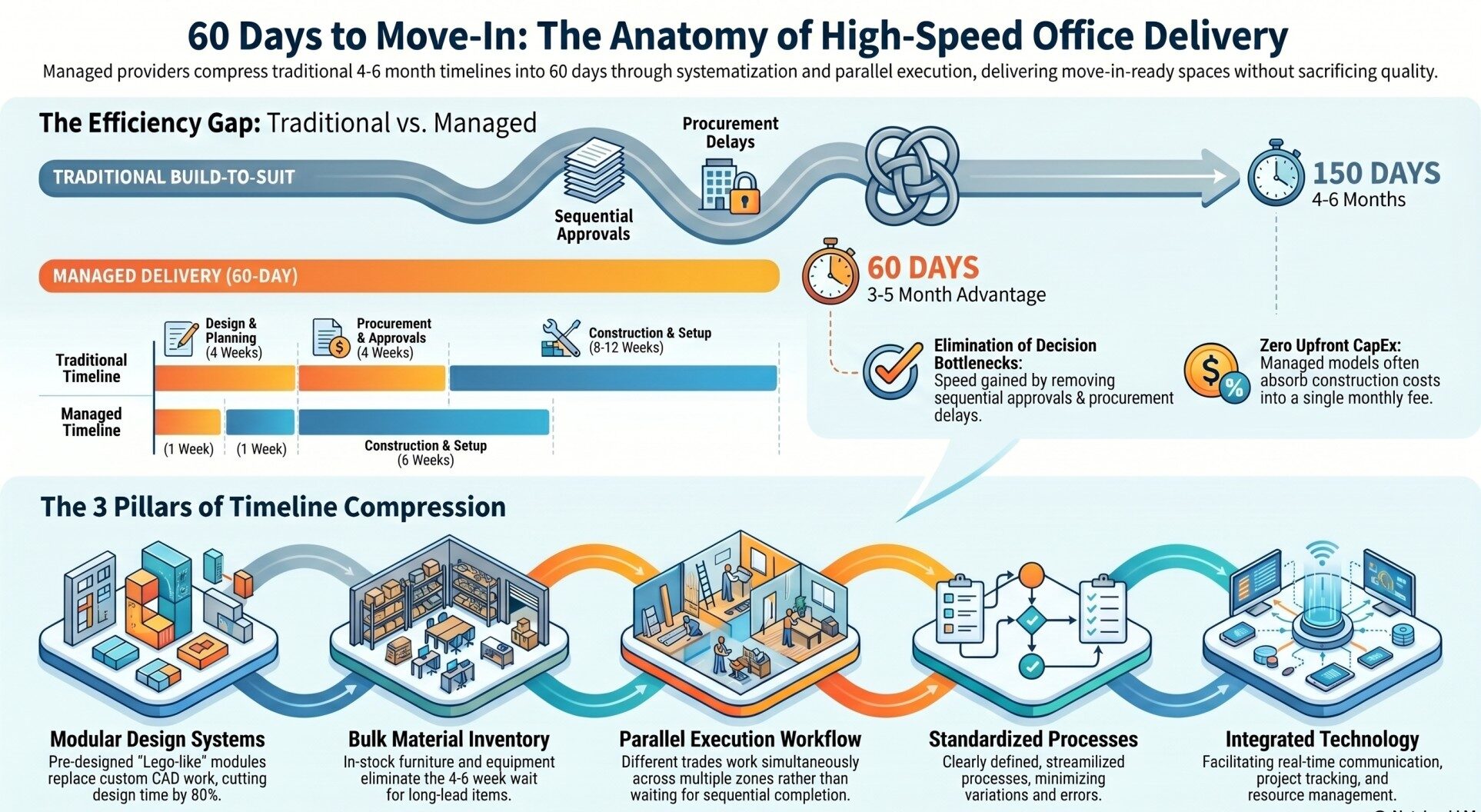

Managed office providers deliver fully operational 50-100 seat offices in 60 days versus 4-6 months for traditional build-to-suit. Speed comes from modular design systems, pre-negotiated vendor relationships, bulk material procurement, parallel execution, and elimination of client decision bottlenecks. Companies needing fast deployment—new GCC launches, contract wins, emergency relocations—gain 3-5 month time advantage.
When companies compare flex versus traditional office leases, one factor often gets lost in cost analysis: timeline to occupancy. Traditional build-to-suit requires 4-6 months from lease signing to operational workspace. Managed providers like AIHP deliver fully functional offices in 60 days.
For companies with immediate deployment needs—launching GCC operations, onboarding teams after major contract wins, or relocating due to infrastructure failures—this 3-5 month time compression has real financial value. The question isn’t just “can you deliver faster?” It’s “how do you compress timeline without compromising quality?”
Here’s how the 60-day delivery model actually works.
Why Traditional Build-to-Suit Takes 4-6 Months
Standard build-to-suit timeline looks like this:
Weeks 1-4: Design and planning
– Site survey and measurements
– Requirements gathering and brief development
– Conceptual design iterations
– Vendor selection for interior contractor
– Material selections and approvals
– Detailed design development
– Budget finalization
Weeks 5-8: Approvals and procurement
– Fire NOC applications
– Building management approvals
– Electrical load approvals
– Material procurement begins
– Long-lead items ordered (custom furniture, imported finishes)
– Contractor mobilization
Weeks 9-16: Construction
– Electrical and HVAC rough-in
– Partition installation
– Flooring and ceiling work
– Paint and finishes
– Furniture installation
– Equipment setup
Weeks 17-20: Testing and handover
– HVAC balancing and testing
– Network infrastructure testing
– Fire system testing
– Punch list completion
– Final inspections
– Handover and move-in
Total: 16-20 weeks (4-5 months) if everything goes smoothly. Reality is 5-6 months with inevitable delays.
The bottlenecks aren’t construction speed—they’re decision points, approvals, procurement lead times, and sequential execution.
How Managed Providers Compress to 60 Days
Managed office providers compress this 4-6 month timeline to 8-9 weeks through five operational strategies:
1. Modular Design Systems Eliminate Custom Design Phase
Instead of starting with blank CAD file, managed providers work from library of pre-designed modules that snap together like Lego.
AIHP maintains design templates for:
– Standard workstation layouts (open plan, team clusters, hybrid models)
– Meeting room configurations (small 4-person, medium 8-person, large 12-person, boardrooms)
– Collaboration zones and breakout areas
– Reception and waiting areas
– Pantry and amenity spaces
When client specifies 60 seats with 4 meeting rooms and team-based layout, designer isn’t creating from scratch. They’re assembling proven modules, adjusting for actual space dimensions, and customizing branding elements.
Design phase compresses from 3-4 weeks to 3-5 days. Client reviews layouts, selects finishes from curated palette, approves branding elements. No endless iteration loops.
2. Pre-Negotiated Vendor Relationships Remove Procurement Delays
Traditional build-to-suit means tendering every trade—electrical, HVAC, partitions, flooring, furniture, IT. Each tender takes 1-2 weeks. Managed providers maintain standing relationships with preferred vendors across all trades.
AIHP works with established network of:
– Electrical contractors (pre-approved rates, known quality)
– HVAC specialists (standardized equipment, fast deployment)
– Partition and ceiling contractors (modular systems, quick install)
– Furniture suppliers (bulk inventory, 2-week delivery)
– Flooring vendors (carpet tiles, engineered wood, vinyl—all in stock)
– Technology providers (network, AV, access control)
No vendor selection process. No negotiation. Rates are pre-fixed through annual contracts with volume commitments. Purchase orders go out same day as design approval.
Procurement phase compresses from 3-4 weeks to 2-3 days.
3. Bulk Material Procurement Eliminates Long-Lead Items
Traditional fit-out waits 4-6 weeks for custom furniture, imported finishes, or specialty equipment. Managed providers maintain inventory of high-turnover items.
AIHP keeps buffer stock of:
– Modular workstation systems (Herman Miller, Haworth, Godrej—multiple lines)
– Standard chairs (task chairs, executive chairs, visitor chairs)
– Meeting tables and conference furniture
– Partition systems (glass, drywall, fabric panels)
– Flooring materials (carpet tiles in 8-10 colors, vinyl planks)
– Standard lighting fixtures
– HVAC equipment (VRV units, FCUs, AHUs in common capacities)
Custom elements (branded graphics, specialty finishes, client logos) are the only long-lead items. Everything else ships from inventory within 1-2 weeks.
Material lead time compresses from 4-6 weeks to 1-2 weeks.
4. Parallel Execution Replaces Sequential Workflow
Traditional build-to-suit runs sequential: finish electrical before starting partitions, complete partitions before flooring, finish flooring before furniture. Each trade waits for previous to complete.
Managed providers run parallel execution wherever possible:
Week 1-2:
– Electrical rough-in starts in zones 1-2
– HVAC modifications begin simultaneously
– Partition materials arrive and stage
Week 2-3:
– Partitions install in zones 1-2 (where electrical is complete)
– Electrical rough-in continues in zones 3-4
– Flooring materials arrive
Week 3-4:
– Flooring installs in zones 1-2 (where partitions are complete)
– Partitions install in zones 3-4
– Furniture arrives and stages
Week 4-5:
– Furniture installs in zones 1-2 (where flooring is complete)
– Flooring installs in zones 3-4
– IT infrastructure runs throughout
Week 5-6:
– Final furniture placement all zones
– Equipment installation (printers, TVs, AV)
– Testing and punch list
This zonal, parallel approach means multiple trades work simultaneously without interfering. Overall construction compresses from 8-10 weeks to 5-6 weeks.
5. Standardized Approvals Process Removes Bureaucratic Delays
Building management approvals can take 2-4 weeks in traditional build-to-suit: fire NOC, electrical load approval, structural clearance for partition loading, wet area waterproofing approvals.
Managed providers in their own buildings or long-term leased buildings have pre-negotiated approval frameworks. AIHP has blanket approvals for:
– Standard partition systems (pre-approved loading, fire rating)
– Electrical modifications within defined capacity limits
– HVAC balancing for standard densities
– Standard wet area specifications
Only non-standard modifications require fresh approvals. Most 50-100 seat fitouts use standard configurations, getting same-day or 2-3 day approvals.
Approval phase compresses from 2-4 weeks to 2-5 days.
The 60-Day Timeline Breakdown
Bringing it all together, here’s actual 60-day managed office delivery timeline:
Days 1-7: Design finalization
– Day 1: Site handover, client brief
– Days 2-3: Modular layout design using templates
– Days 4-5: Client review, finish selections
– Days 6-7: Final approvals, branding elements finalized
Days 8-14: Procurement and mobilization
– Day 8: Purchase orders to all vendors
– Days 9-12: Material procurement from inventory
– Days 13-14: Site mobilization, equipment staging
Days 15-42: Construction (4 weeks)
– Weeks 3-4: Zone 1-2 electrical, partitions
– Weeks 4-5: Zone 1-2 flooring, Zone 3-4 partitions
– Weeks 5-6: Zone 1-2 furniture, Zone 3-4 flooring, IT throughout
– Week 6: Final furniture all zones, equipment install
Days 43-56: Testing and commissioning
– Days 43-48: HVAC balancing, network testing, fire system check
– Days 49-52: Punch list completion
– Days 53-56: Final inspections, cleaning, staging
Days 57-60: Handover
– Day 57-58: Walk-through with client
– Day 59: Keys handover, access provisioning
– Day 60: Move-in ready
Total: 8-9 weeks (60 days) from design brief to operational workspace.
What Customization Is Still Possible?
Common objection: “60-day delivery means I get generic cookie-cutter space, right?”
Not exactly. Managed providers compress timeline through systematization, not standardization. Here’s what’s customizable within 60-day model:
Layout configuration:
– Open plan vs team-based clusters vs hybrid
– Meeting room quantity and size distribution
– Collaboration zone locations and types
– Manager cabin vs open seating
– Workstation density (tight 40 sq ft/seat vs spacious 60 sq ft/seat)
Finish selections:
– Flooring type and color (8-10 options in stock)
– Partition fabric or paint colors (curated palette)
– Workstation panel colors and configurations
– Meeting room aesthetics
– Pantry finishes and equipment
Branding elements:
– Reception wall branding and graphics
– Way-finding signage
– Meeting room naming and graphics
– Brand colors throughout space
Technology specifications:
– Network backbone and WiFi density
– AV equipment in meeting rooms
– Access control sophistication
– Printers and equipment specs
What’s not customizable within 60 days: imported materials, fully custom furniture, structural modifications requiring extensive approvals, non-standard HVAC or electrical beyond building capacity.
For companies needing extreme customization, managed providers can extend timeline to 90-120 days—still faster than traditional 4-6 months because core systems remain modular.
When 60-Day Delivery Creates Real Value
Fast deployment isn’t just nice-to-have. It creates tangible financial value in specific situations:
New GCC or captive center launches:
Global companies opening Indian GCC operations face hard deadlines: leadership visits scheduled, initial teams hiring, onboarding timelines committed. Waiting 5-6 months for traditional fit-out delays revenue recognition, extends bench time for hired employees, and misses market windows.
60-day delivery means operational workspace ready before first employee batch starts, eliminating 3-4 months of unproductive rent payment.
Contract wins requiring immediate team ramp:
Company wins major outsourcing contract starting in 90 days. They need to onboard 75 people, train them, and be operational. Traditional 4-6 month fit-out timeline means they miss contract start date or scramble for temporary space.
60-day delivery lets them sign lease, complete fit-out, and onboard team within contract timeline—no interim arrangements, no lost revenue, no client disappointment.
Emergency relocations:
Building infrastructure failure, fire safety issues, or operational problems force immediate relocation. Company has 60-90 days to vacate current space. Traditional fit-out timeline is impossible.
60-day delivery provides escape hatch—they can relocate entire team without extended temporary arrangements or business disruption.
Market timing and competitive response:
Competitor opens office in target market. Company needs presence quickly to compete for talent and clients. Waiting 5-6 months means competitor establishes position unopposed.
60-day delivery allows fast market entry—claim talent, establish presence, respond to competitive moves.
In each case, time compression has direct financial value: earlier revenue recognition, avoided interim space costs, competitive positioning, contract compliance.
The Trade-Off: Cost vs Speed vs Customization
No model is optimal for all situations. The 60-day delivery model makes specific trade-offs:
What you gain:
– 3-5 month time advantage over traditional build-to-suit
– Reduced project risk (proven modular systems, known vendors)
– Preserved capital (no upfront CapEx vs traditional lease)
– Operational simplicity (single vendor vs coordinating multiple contractors)
What you trade:
– Some customization flexibility (work within modular system)
– Slightly higher monthly costs vs traditional lease (as covered in flex vs traditional analysis)
– Limited ability to specify exotic materials or finishes
– Dependence on provider’s design aesthetic and systems
For companies where time is critical resource and requirements fit within managed provider’s modular systems, the trade-off heavily favors 60-day model.
For companies with unlimited timeline, extreme customization needs, or strong preference for ownership of every specification decision, traditional build-to-suit remains appropriate despite longer timeline.
📥 RESOURCE: Access AIHP’s Design Portfolio to see examples of spaces delivered through the 60-day model across different industries, team sizes, and aesthetic requirements. Portfolio includes layouts, specifications, and timeline documentation.
Conclusion: Speed as Strategic Capability
The 60-day office delivery model isn’t magic—it’s systematization. Managed providers compress traditional 4-6 month timelines through modular design systems, pre-negotiated vendor relationships, bulk procurement, parallel execution, and streamlined approvals.
This speed creates real competitive advantage for companies facing hard deadlines: GCC launches with committed start dates, contract wins requiring immediate ramps, emergency relocations, or market timing imperatives.
The model requires accepting some constraints on customization and slightly higher monthly costs compared to traditional lease. But for companies where time is critical resource—and that’s increasingly common in fast-moving markets—the ability to go from lease signing to operational workspace in 60 days changes strategic options.
Companies evaluating Gurgaon office space should assess not just cost and location, but timeline to occupancy. In situations where 3-5 month time advantage translates to earlier revenue, avoided interim costs, or competitive positioning, the 60-day model isn’t faster—it’s strategically superior.
For information on 60-day delivery timelines and feasibility for your specific requirements, get in touch with AIHP.
Frequently Asked Questions
Managed providers compress timelines through five strategies: (1) Modular design systems eliminate 3-4 week custom design phase by using pre-designed templates that assemble in 3-5 days. (2) Pre-negotiated vendor relationships remove 3-4 week procurement process—POs go out in 2-3 days. (3) Bulk material inventory eliminates 4-6 week long-lead items—most materials ship in 1-2 weeks. (4) Parallel execution runs multiple trades simultaneously versus sequential workflow, compressing 8-10 week construction to 5-6 weeks. (5) Standardized approvals in managed buildings take 2-5 days versus 2-4 weeks for custom approvals. These compress 16-20 week traditional timeline to 8-9 weeks.
Within 60-day timeline, companies can customize: layout configuration (open vs team-based, meeting room distribution, collaboration zones), finish selections (flooring colors, partition fabrics, workstation configurations from curated palette), branding elements (reception graphics, signage, brand colors), and technology specifications (network density, AV equipment, access control). What's not possible in 60 days: imported materials requiring 8-12 week lead times, fully custom furniture designed from scratch, structural modifications requiring extensive approvals, specialized HVAC or electrical beyond building capacity. For extreme customization, timeline extends to 90-120 days—still faster than traditional 4-6 months.
No. Speed comes from systematization, not cutting corners. Managed providers use same-quality materials and equipment as traditional fit-out: branded modular furniture (Herman Miller, Haworth, Godrej), proper HVAC systems with individual zone control, commercial-grade electrical and data infrastructure, fire-rated partition systems, and 3-year warranty on AC and lighting. Difference is these are pre-selected, pre-approved, bulk-procured systems versus custom-specifying everything. Quality is maintained through standardization—proven systems installed repeatedly versus one-off experimental specifications. Many 60-day delivered spaces exceed quality of rushed traditional fit-outs where contractors cut corners to meet impossible deadlines.
60-day delivery through managed office model costs ₹15-20K per seat monthly versus ₹10-14K base rent for traditional lease, but traditional requires ₹2-3.5 lakhs per seat upfront CapEx that managed model avoids. Over 3 years, managed is often cheaper when factoring total costs (see flex vs traditional comparison article). However, if comparing only construction costs: managed provider absorbs fit-out CapEx into monthly fee, traditional tenant pays ₹2-3.5 lakhs/seat upfront. For 50-seat office, that's ₹1-1.75 crores upfront in traditional versus zero in managed. Monthly difference is ₹2.5-6 lakhs (₹30-72 lakhs annually), so managed pays back avoided CapEx in 18-30 months.
Choose traditional build-to-suit when: (1) Timeline is flexible—you have 6-9 months before occupancy needed. (2) Extreme customization required—labs, secure facilities, specialized HVAC, imported materials not in managed provider inventory. (3) Very large space—200+ seats where managed provider modular systems don't scale efficiently. (4) Long-term stable occupancy (7-9+ years) where CapEx investment amortizes fully. (5) Strong preference for owning every specification decision versus working within managed provider systems. For most companies under 150 seats with 3-5 year occupancy horizon and 60-90 day deployment timeline, 60-day managed model is superior.
